POWERING SCIENCE

CERN’s unique array of accelerators, detectors, computing and other technical infrastructure is primarily powered by electricity, accounting for about 95% of CERN’s total energy use. Its flagship accelerator, the Large Hadron Collider (LHC), accounts for some 55% of the total consumption. In 2023 and 2024, which were both operation (‘Run’) years, CERN’s electricity consumption amounted to 1 096 GWh (3 946 TJ) and 1 290 GWh (4 645 TJ), respectively. In 2023, in the wake of the energy crisis, accelerator operation was reduced by 20% by extending the Year End Technical Stop (YETS) to 19 weeks, leading to savings of about 70 GWh of electricity.

Specific projects to renovate the ventilation and cooling systems of the accelerators are under way with a view to achieving energy gains of 8 GWh per year. In this vein, during the reporting period, the ventilation system that cools the Meyrin data centre was fully renovated, including installation of variable-speed drives. Since 2022, to further foster energy savings, the LHC cryogenic installations have been operating in “eco mode” whenever possible, leading to energy savings of up to 20 GWh per year.

The Laboratory also uses natural gas for heating, fuel for its fleet of vehicles and diesel for emergency generators, and consumed 43 GWh (154 TJ) of fossil fuels in both 2023 and 2024. It also uses commercial liquid nitrogen for cooling and small amounts of photovoltaic energy produced on the CERN site.

CERN’s frontier physics programme relies upon ever more data being delivered to the experiments, which is measured in the LHC by a parameter known as luminosity. Higher luminosity increases the number of proton-proton collisions, hence data collection, enhancing statistical precision and the potential for discoveries. However, it can also lead to higher electricity consumption.

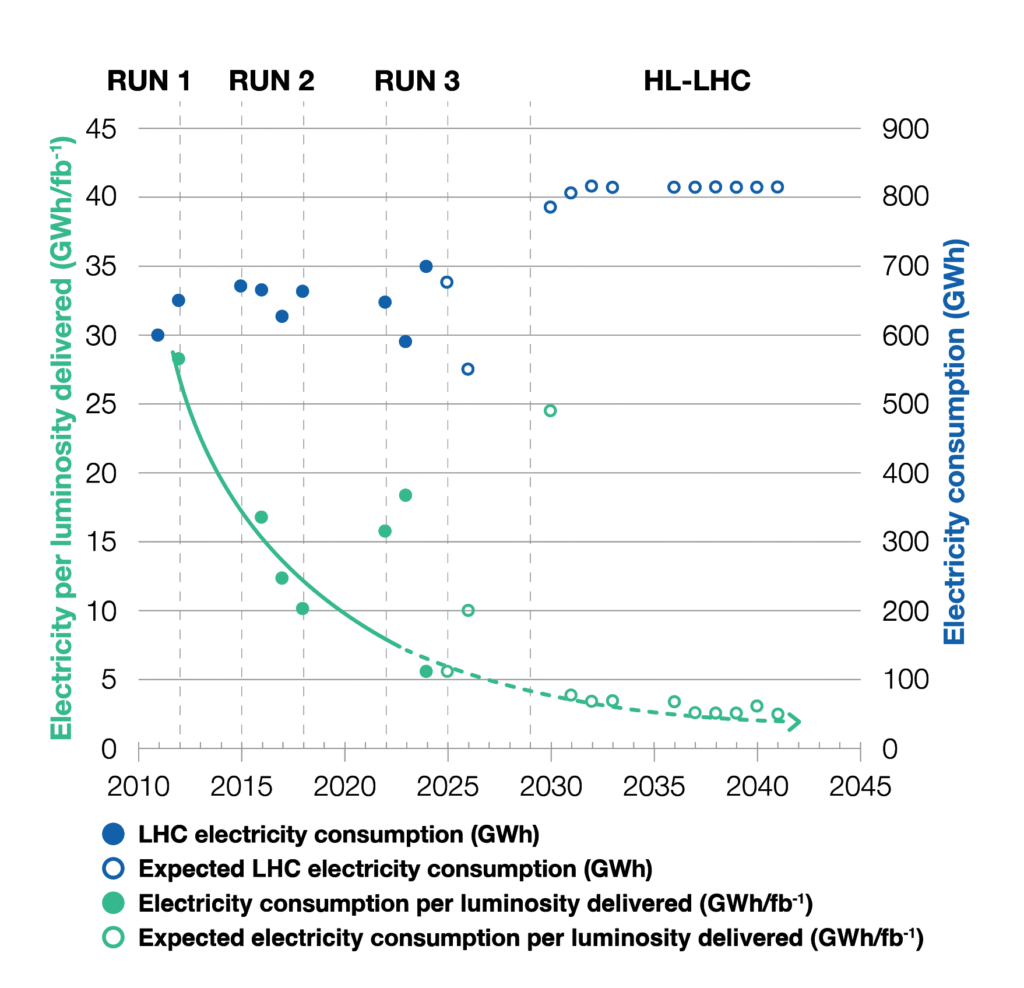

In addition to limiting the increase in electricity consumption to 14% during High-Luminosity LHC (HL-LHC) compared with the consumption in Run 3, CERN is committed to improving energy efficiency by maximising the luminosity delivered per unit of energy consumed. Between Run 1 and the end of Run 2 (i.e., from the start of the LHC to 2018), the LHC’s efficiency in this regard tripled. With the HL-LHC, a further improvement by a factor of four is projected.

CERN’S ENERGY STRATEGY

CERN’s Energy Management Panel (EMP), established in 2015, drives CERN’s energy strategy, which spans three pillars: increase efficiency, use less, and recover waste energy. CERN’s energy management approach is further strengthened by the CERN Energy Policy (published in 2022), a dedicated energy coordinator and the enlarged EMP, which meets regularly to include all of CERN’s activities beyond the accelerator complex. Furthermore, CERN collaborates closely with its Host States through the tripartite committee for the environment (Comité Tripartite pour l’Environnement – CTE), which was established in 2007, and with its grid operators and electricity suppliers.

Energy procurement currently represents 5 to 10% of CERN’s annual budget when the accelerators are running, and less during shutdown periods. Electricity is primarily procured from France, whose energy grid mix is more than 95% low carbon (2024).

In the context of CERN’s Environmentally Responsible Procurement Policy Project (see Procurement and Materials), procurement guidelines for equipment, products and services have been established in which energy performance over the planned or expected operating lifetime is one of the criteria. This applies to the procurement of any item where power exceeds 500 kW or annual energy consumption exceeds 5 GWh.


OPTIMISING ENERGY ACROSS THE CAMPUS

The energy that the Organization needs to power its buildings and general infrastructure represents about 10% of its total consumption. Continuous optimisation efforts are underpinned by an extensive consolidation programme that spans five years and is reviewed annually in the case of the heating, electrical, ventilation and air conditioning infrastructure. The Office Cantonal de l’Energie (OCEN) in Geneva, Switzerland, notably contributes to financing such consolidation work on the Meyrin site.

Specific measures further support CERN’s efforts to minimise energy use. These measures include delaying the annual start-up of district heating, adapting it to the weather conditions and reducing the temperature of the boilers, representing gas savings of 15 GWh per year compared to pre-2022 levels. A campaign was launched in 2023 to replace halogen lamps with energy-efficient LEDs in tertiary buildings. By the end of 2024, the project was 95% complete with some 50 000 lamps replaced, resulting in total electricity savings of approximately 3 GWh per year.


COMPUTING AND IT INFRASTRUCTURE

The High-Luminosity LHC (HL-LHC) project is expected to deliver a tenfold increase in the amount of physics data collected during its period of exploitation (scheduled to end in 2041) compared to the original LHC design, leading to a considerable rise in the computing capacity required by the experiments. CERN is committed to balancing the associated rise in energy needs through strategic planning aimed at optimising the computing infrastructure and its hardware and software tools. Ongoing efforts focus on modernising code, optimising its performance for the latest hardware, and improving data management. By developing innovative approaches to key computing tasks – including machine learning and related technologies – CERN is progressing in reducing the overall computing resources required, helping to limit energy consumption growth.


The new data centre in Prévessin, inaugurated in February 2024, is designed to provide up to 12 megawatts (MW) of power capacity for computing, to be deployed in three phases in line with CERN’s evolving needs. The upgrade to Phase 2 (8 MW) is scheduled for 2027/2028 to meet the demands of the first run of HL-LHC (Run 4). The data centre targets a power usage effectiveness (PUE) of around 1.1 — a level of energy efficiency significantly better than the industry average, where large data centres typically operate at PUEs of 1.5 and new facilities achieve between 1.2 and 1.4 (with a score closer to 1.0 indicating higher efficiency). The Meyrin data centre, with a PUE of below 1.5, is housed in a 1970s building that was not originally designed for modern computing equipment, making further optimisation challenging. It will continue to operate, focusing mainly on storage activities that are better suited to its lower power density. Plans to enhance its power efficiency and improve sustainability, for example by reducing the number of UPS systems and batteries, are under discussion.

Growing awareness across computing and physics communities, along with rising energy costs and regulatory requirements, are driving a stronger commitment to sustainable computing practices. The WLCG collaboration at large is engaged collectively in assessing new methods and technologies to minimise environmental impact. In this vein, the first WLCG sustainability workshop was held in December 2024 to further foster collaboration, share best practices and drive efficiency across the network. The first main objectives include setting up a framework to collect information related to energy efficiency, to facilitate the use of more energy-efficient hardware where possible and to develop and promote a sustainability plan to improve energy efficiency and reduce carbon footprint. The objectives cover software, computing models, facilities, and hardware technology and lifecycle.


IN FOCUS

Nicolas Bellegarde is CERN’s energy coordinator.

— What steps did CERN take to evaluate the potential use of solar energy to meet part of its electricity needs?

NB: Diversification of energy sources is part of the Organization’s energy strategy, in line with the ISO 50001 requirements. Photovoltaic power has been under consideration for some time and we first revisited whether the CERN campus infrastructure, through use of its roofs and car parks, could be leveraged to install sufficient solar panels to meet 10% of our electricity needs. A study was undertaken in collaboration with Swiss Solar City, a company that specialises in equipping car parks and roofs with solar panels. This revealed that the potential accessible areas at CERN spanned some 100 parking spaces and a further 5000-10 000 m2 of roof surfaces, with no tangible technical or economic benefits. We therefore continued our search with external partners in the form of power purchase agreements (PPAs).

— What is the scope of the resulting PPA contracts signed at the end of 2024?

NB: The PPAs concerned will secure the supply of electricity from planned solar power plants in the Lozère, Bouches-du-Rhône and Var departments in southern France, giving access to a total area of approximately 90 hectares (900 000 m2) of solar panels, equivalent to more than 120 football pitches. This is equivalent to about 40% of CERN’s fenced area; a project of this scale would have been unfeasible on the CERN site. The aim is that CERN should start to receive electricity from these plants as of January 2027. CERN has committed to purchasing electricity produced by the solar plants, representing a total of 95 MW peak power and a supply of 140 GWh/year over a period of 15 years.
